Projects
To Bid on Projects please visit City of Ogden Purchasing Homepage link for active bid opening. Purchasing Homepage
FUNDED PROJECTS
April 2022
- Replacement of Antiquated Airport Generator with Larger Capacity Generator
- Schedule for Completion - April 2022
- COMPLETED APRIL 2022
- Replacement of Hangar 755 Roof
- Out for Bids - March 2022
- Construction - June 2022
- Schedule for Completion - September 2022
November 2021
- Repair Pilot Control Lighting System Multiple Level Light Intensity
- Installation - November 2021
- Schedule for Completion - Mid-December 2021
- COMPLETED MARCH 2022
October 2021
- Demolition of Hangar N-850
- Out for Bids - October 2021
- Demolition - Mid-January 2022
- Scheduled for Completion - March 2022
- COMPLETED MARCH 2022
September 2021

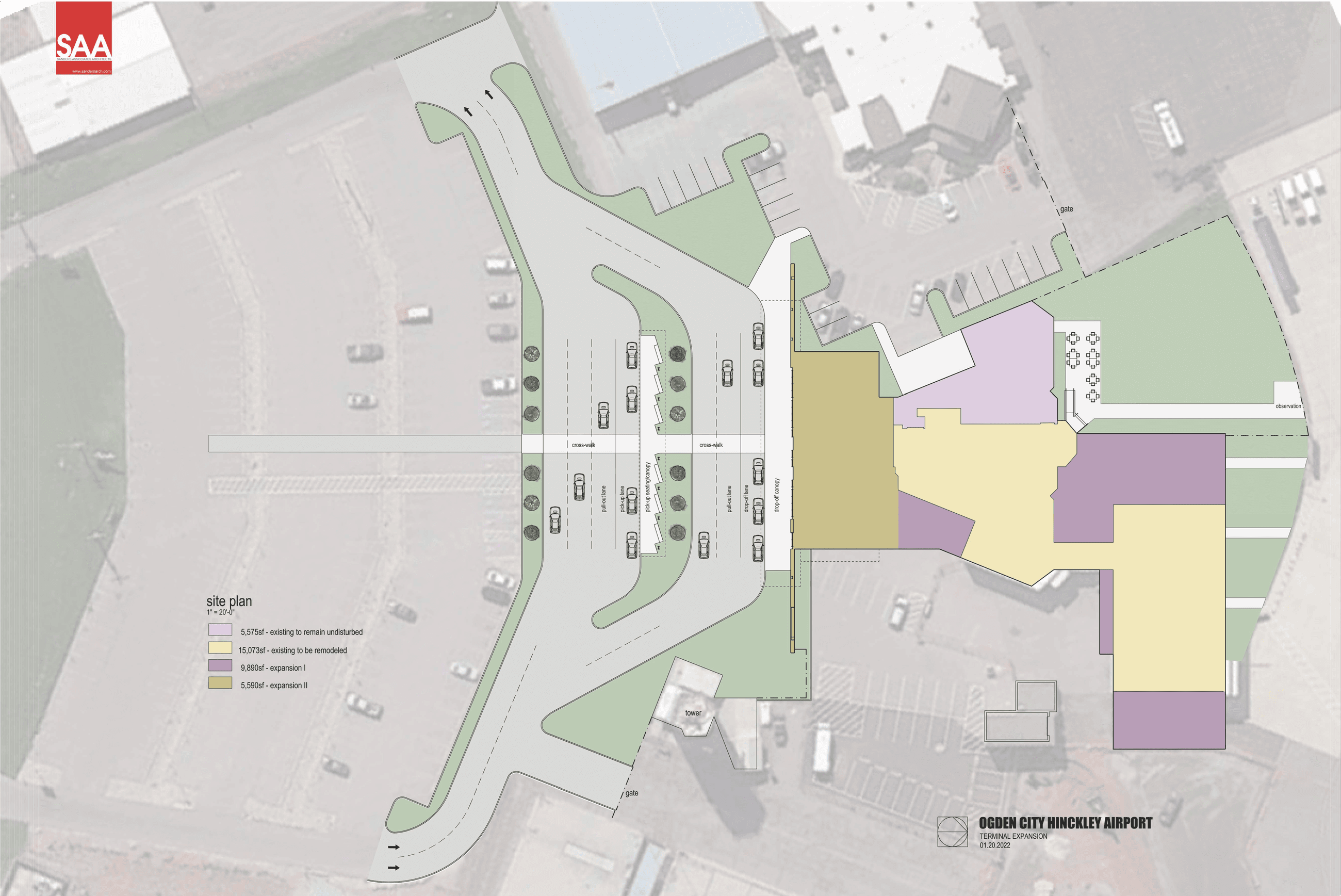

- Design of $2 Million Expansion of Airport Terminal
August 2021
- Remodel of Restaurant in Terminal
- Design - Completed August 2021
- Out for Bids - September 2021
- Construction - October 2021
- Schedule for Completion - March 2021
- COMPLETED APRIL 2022
July 2021
- Demolition of Old Tower on Top of Terminal Building.
- COMPLETED AUGUST 2021
June 2021
- Demolition of Hangars N-420, S-543, S-553.
- COMPLETED JUNE 2021
- Construction of Fiber Optic Network Loop Around OGD Airport for Internet Access / Data Transmission.
- Out for Bids - June 2021
- Construction Started - August 2021
- Scheduled for Completion - January 2022
- COMPLETED DECEMBER 2021

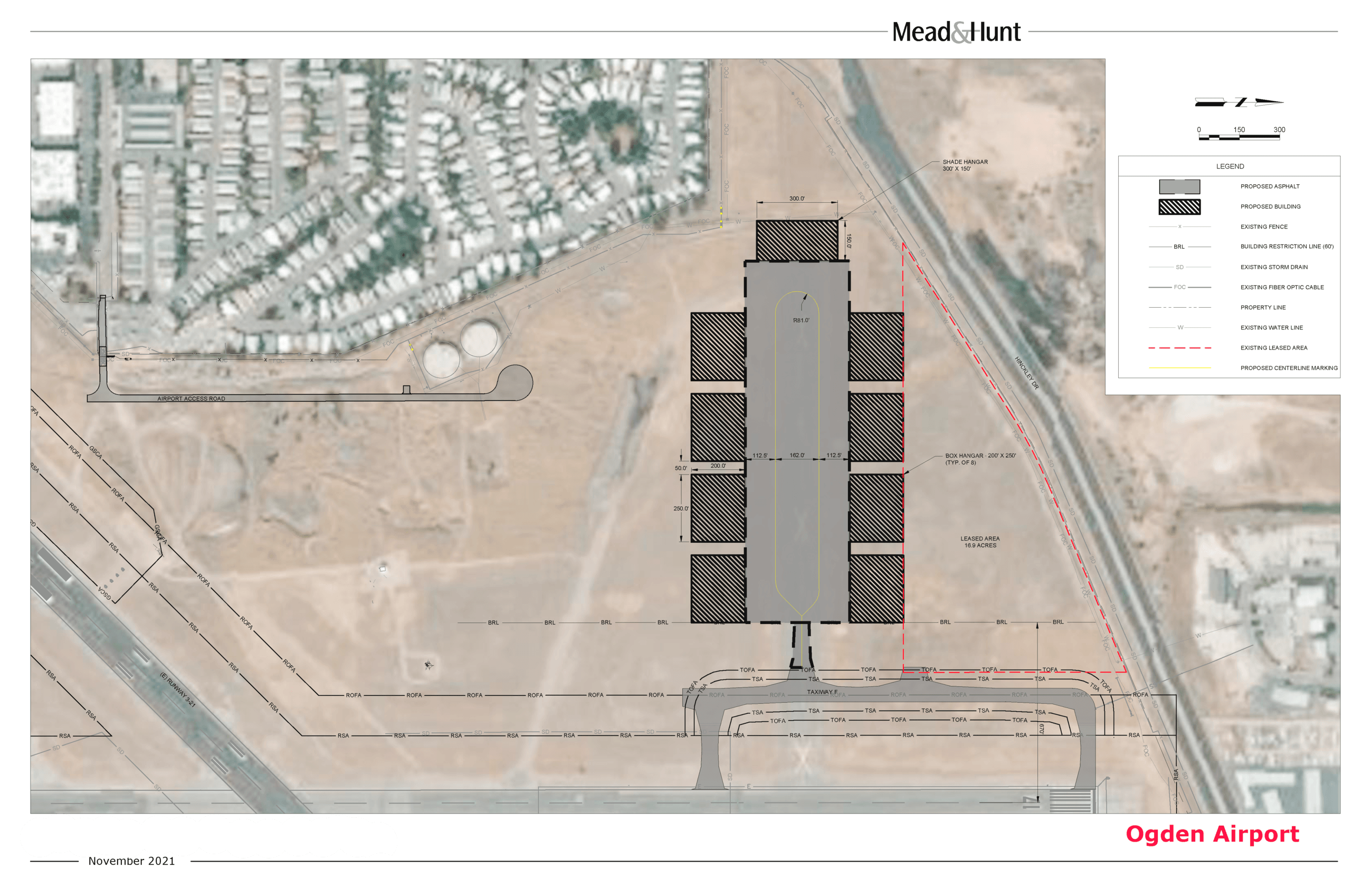

- Maintenance Complex & West Side of Airport Improvements - Grading / Cleanup; Utilities Upgrade; Creation of West Side Entrance.
- Under Design - June 2021 - January 2022 See Diagram below
- Out for Bids - February 2022
- Construction Start - May 2022
- Schedule for Completion - December 2022
- Construction of New Partial Parallel Taxiway Foxtrot, West of Approach End of Runway 17.
- Design - December 2021 See Diagram below
- Out for Bids - March 2022
- Construction - May 2022
- Schedule for Completion - December 2022
June - Sept 2021

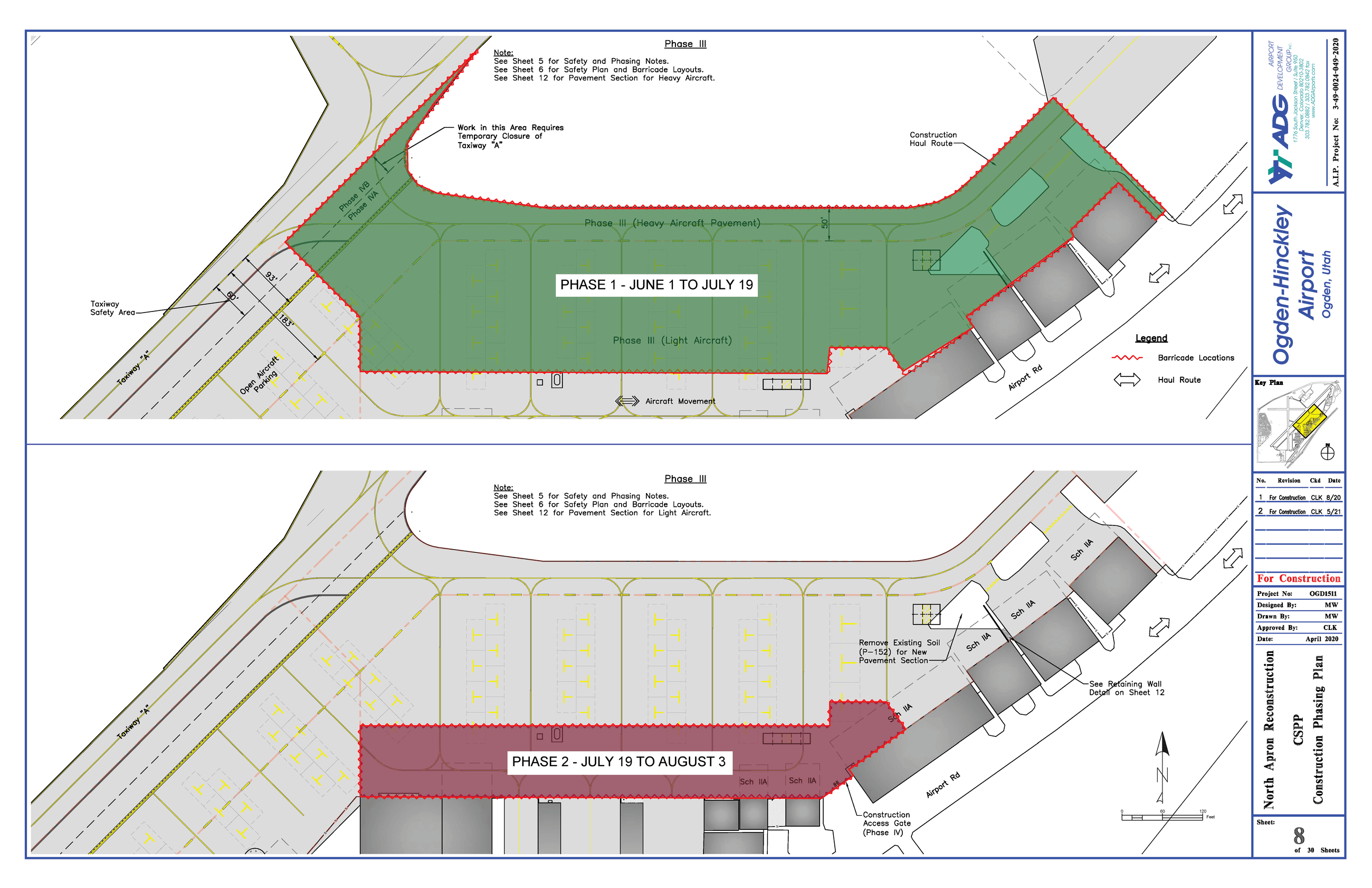

OGD AIRPORT NORTH TIE-DOWN APRON RECONSTRUCTION, SCHEDULE II - COMPLETED DECEMBER 2021
Granite Construction is scheduled to begin the second half of the North Tie-Down Apron Reconstruction on Tuesday June 1st, 2021.
Phase One - June 1st - July 19th
The pavement will be removed airside of four hangars. Each of these hangar owners & users should make arrangements to not have aircraft access in or out of their hangars between June 1st and July 19th.
Affected Hangars - N-1302, the northmost bay only, Hangar N-1410, Hangar N-1460, and Hangar N-1504.
Phase Two - July 19th - August 3rd
Twenty one (21) hangars will lose the ability to get an aircraft from their hangar to the Runway & Taxiways. Each hangar owner or user will need to make arrangements to not have aircraft access in or out of their hangars between July 19th and August 23rd.
Affected Hangars - Hangar N848, Hangar N-824, Hangars N-946, N-942, N-936, N-930, N-924, N-918, N-1038, N-1034, N-1028, N-1022, N-1016 & N-1010, Hangar N-916, Hangar N-1004, Hangar 1108, Hangar N-1116, Hangar N-1110, Hangar N-1204, and Hangar N-1302.
Additional time will be required to core the tie-down anchor points and to paint in the striping and the tie-down "T's".
These dates represent the best estimates for each phase, but the actual times could vary somewhat.
Other Misc. Projects
- Utah 99's Painting of Compass Rose
- Outlining and Painting of 80 ft Compass Rose - May 2022
